Are Your Turnaround Costs Really Comparable?
Why enterprise cost control starts with how contractor cost enters the organization.
Know the number while
there is still time to act.
Vault is turnaround cost tracking software that brings estimating, bids, budgets, cost and manpower reporting, forecasting, and scope changes into one current view—giving leadership real-time cost visibility throughout the event, not weeks after the financial period closes.
Financial systems close on a monthly cycle. Turnarounds move by the shift, leaving leadership to manage current decisions with outdated cost data.
Contractor billing, material spend, internal labor, and commitments live in separate systems and are reconciled manually in spreadsheets.
Work is authorized in the field, then priced and entered later. By the time the impact is visible, the decision has already been made.
Vault uses the same job and progress data driving execution, aligning cost, forecast, and schedule in one current view. As the work changes, the financial outlook changes with it.
See our turnaround cost control guide for the six stages from estimating and bids through daily reporting, forecasting and scope change control.
Contractors submit estimates and bids in one standard format with built-in rates, so quotes can be compared line by line.
Build the cost and manpower budget from approved estimates, then track against it every day.
Track estimated cost, incurred cost, ERP actuals, and forecast at completion on one daily S-curve. Variances against SAP remain visible throughout the event—not just at close-out.

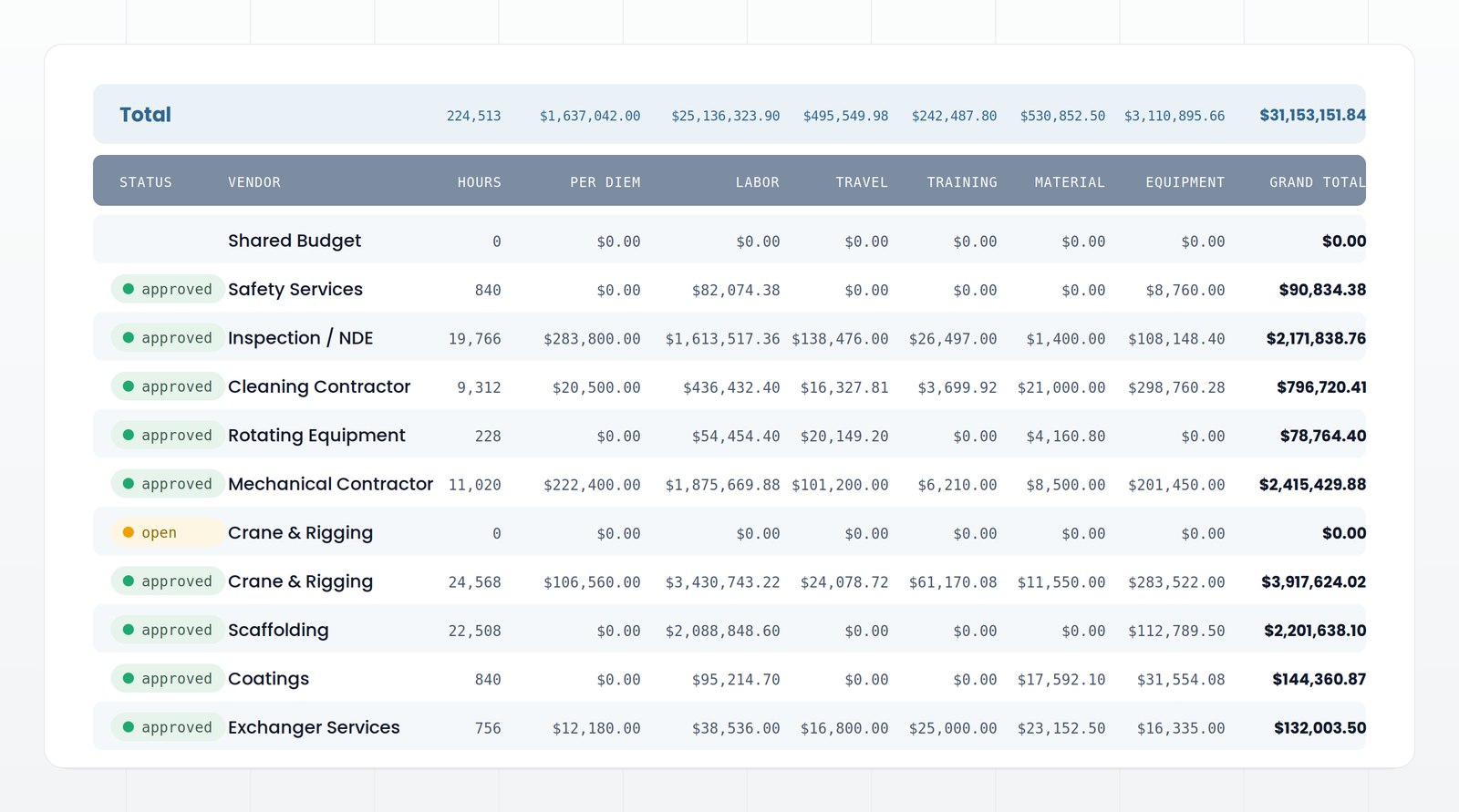

Track labor, hours, per diem, travel, training, materials, and equipment by vendor, with approval status on every entry. Validate contractor charges before they are approved for payment.

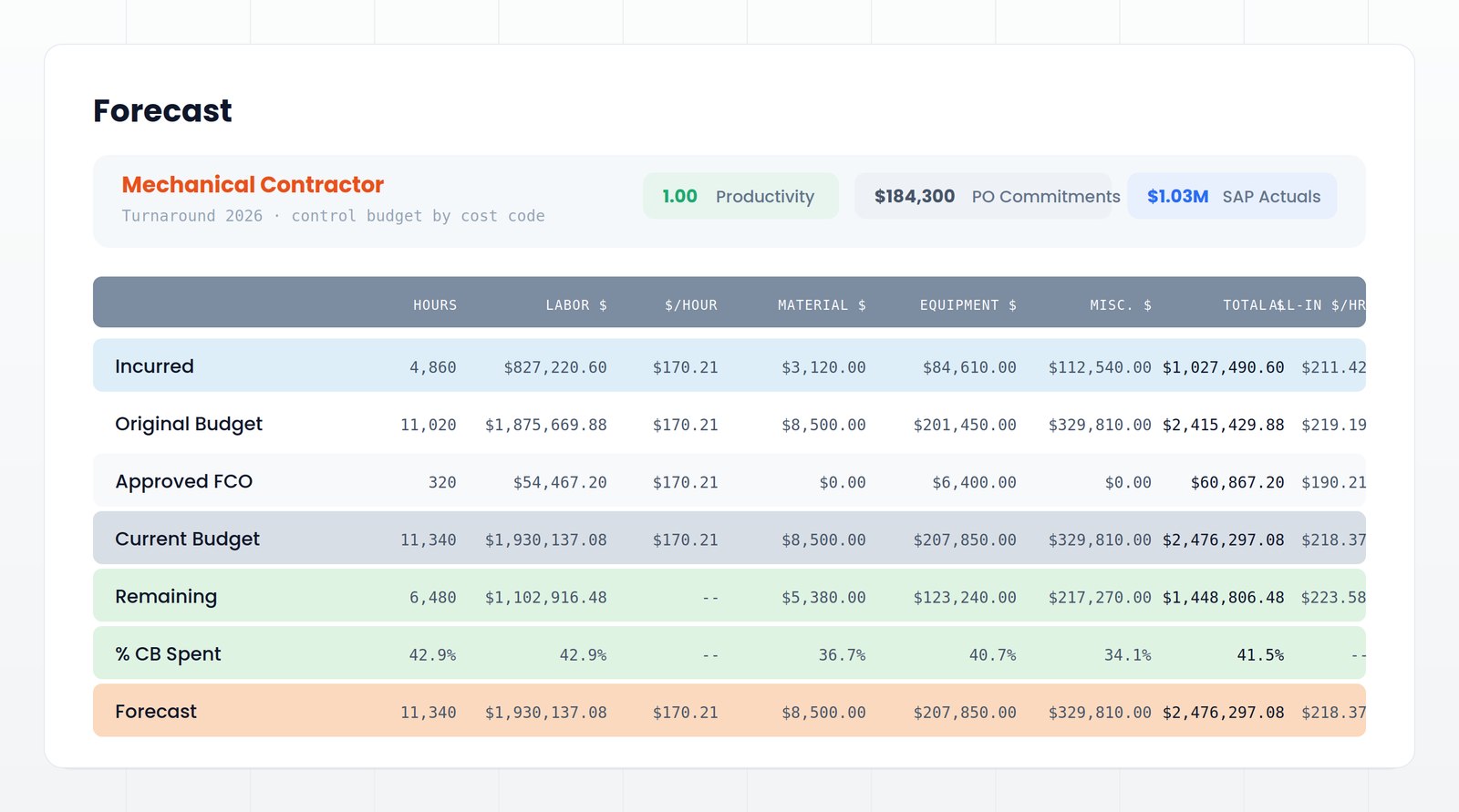

Compare incurred cost against the original budget, approved changes, current budget, and remaining forecast by cost code. Productivity and scope changes update the forecast as the event progresses.

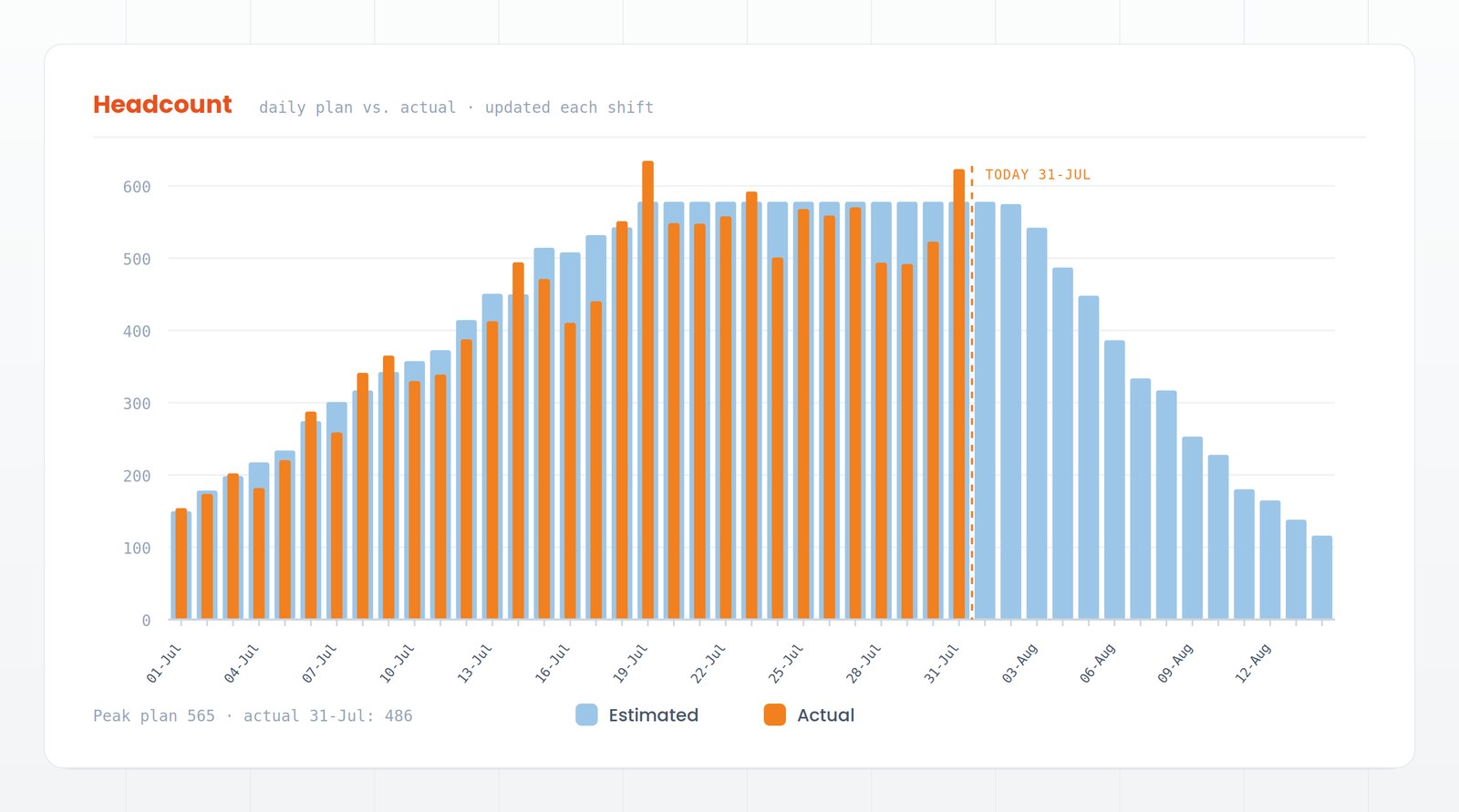

Estimated against actual headcount by day, updated each shift. Overruns and shortfalls are visible while there is still time to move people.
One site consolidated more than 20 spreadsheets and paper forms into EZTRAK.
Read the PBF Torrance case study
Are your turnaround costs really comparable from one event to the next?
Purchase orders, invoices, actuals, and GL codes remain in the system of record.
Work completion data drives real-time productivity scores and forecast updates.
Material commitments, receipts, and issues feed current cost tracking.
Manages commitments, accruals, changes, and the daily forecast.
Reconciles Vault with the financial system and reports current cost performance.
Sees cost, progress, productivity, and forecast in one current view each morning.
Field-level insights into how turnarounds, shutdowns, and outages actually run. No product announcements.
